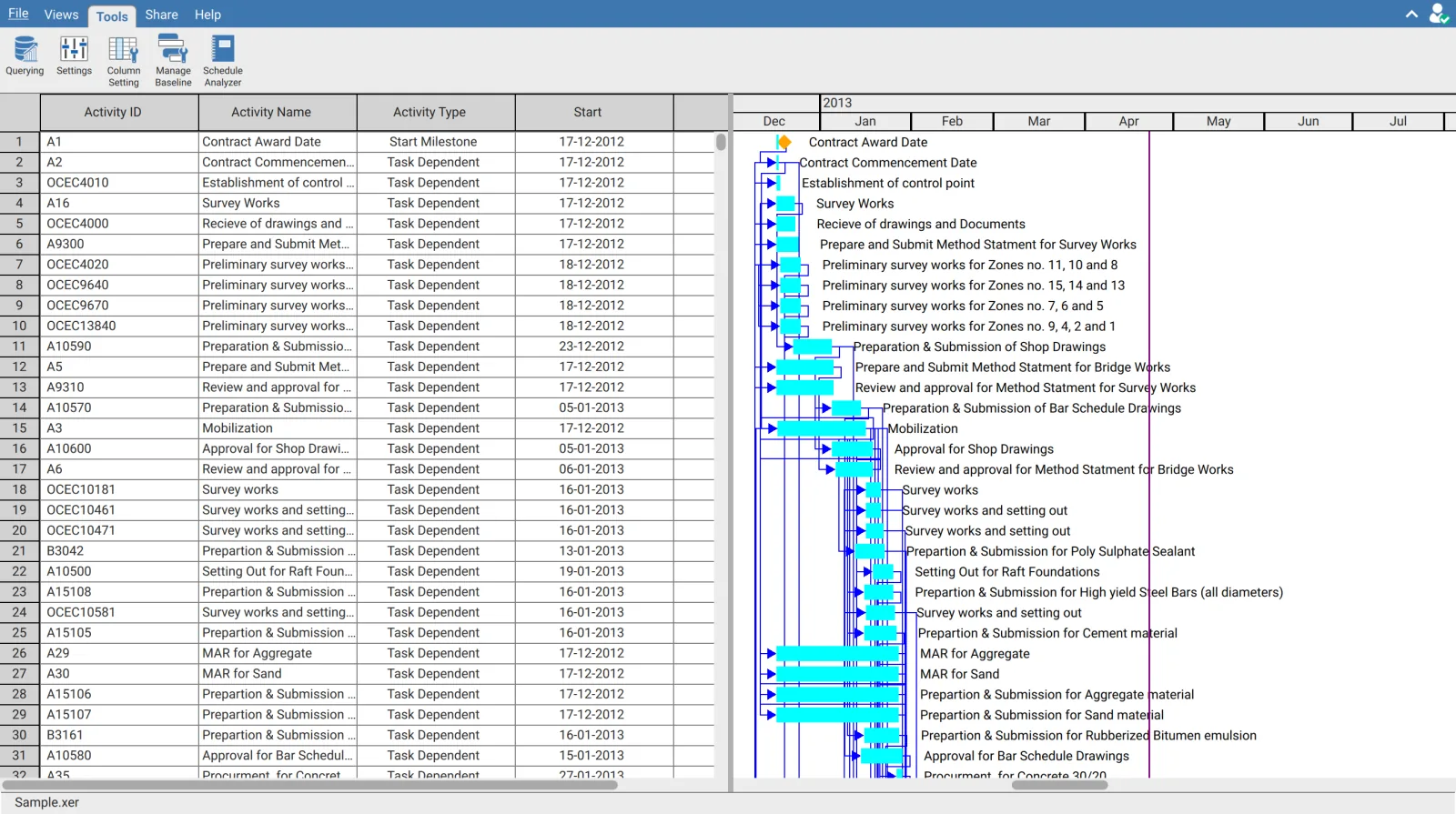

The Schedule Analyzer runs 19 checks against an open schedule and reports each one as a pass or a fail against a configurable limit. It is on the Tools tab, under Schedule Analyzer.

The analysis starts on its own
Clicking Schedule Analyzer opens a full window view titled Schedule Health Assessment and immediately runs the analysis against every project in the file. There is no separate step to start it the first time.

Reading the left panel
| Entry | Meaning |
|---|---|

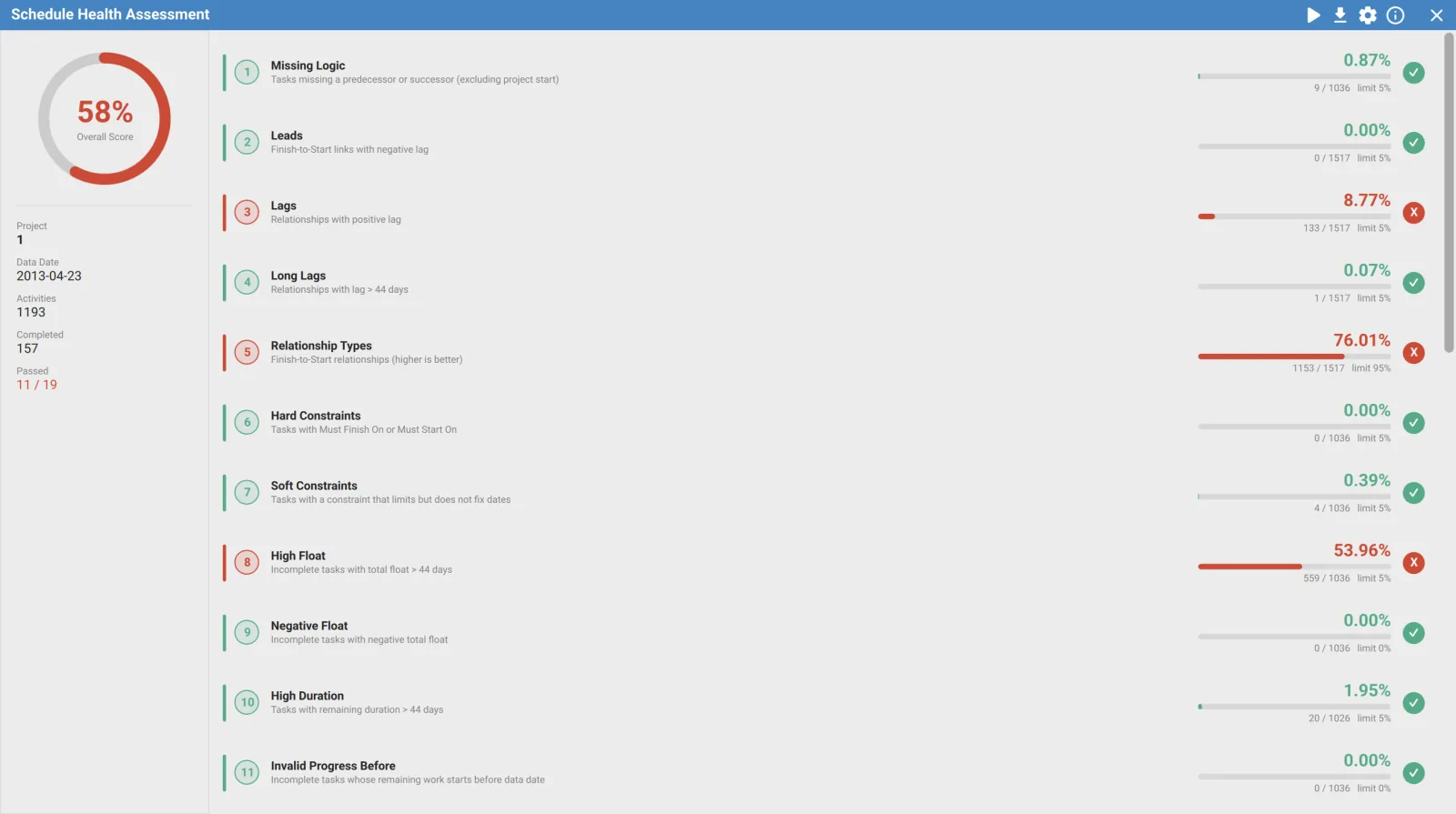

| Overall Score | The percentage of checks that passed. Green at 90 and above, amber from 70, red below 70 |
| Project | The project name the figures relate to |
| Data Date | The project data date the checks are measured against. For a file that has none, its planned start or its latest progress, followed by (planned start) or (estimated) |
| Activities | Total activity count |
| Completed | Activities already finished |
| Passed | Checks passed out of checks run |
Overall Score is a count, not a weighting. It is passed checks divided by checks run. A schedule failing four minor checks scores the same as one failing four severe checks, so read the cards rather than stopping at the number.
Reading a metric card
Every check draws the same card: a numbered badge, the check name with an info button after it, what it looks for, the measured value, the count it came from, the limit, and a pass or fail badge on the right.
| Element | Meaning |
|---|---|
| Value | The measured result, as a percentage or as a ratio |
| Count / total | The offending items over the population the check divided by |
| limit | The configured threshold the value is compared against |
| min | Used instead of limit where the value must reach the figure rather than stay under it: Relationship Types, CPLI and BEI |
| Green tick | Pass |
| Red cross | Fail |
| Grey, --, not measured | The check could not be made, and the card says why: Needs a baseline: pick one above, Needs a baseline: the schedule has none, Needs a data date: the schedule has none or, for CPLI when no activity is critical, Needs critical activities: the critical rule finds none. It is left out of the score and of Passed |
| Data date estimated from the latest progress | The check was measured as of an estimated data date, for a file that has none |
Relationship Types is the check that reads backwards. It is higher is better: the card shows the percentage of Finish to Start relationships and a minimum of 95 percent, labelled min, and it fails when the value is below that figure. Every other percentage check fails when the value is above its limit. CPLI and BEI work the same way.
The 19 checks
| # | Check | What it counts |
|---|---|---|
| 1 | Missing Logic | Incomplete activities missing a predecessor or successor, excluding the project's start and finish. A relationship to a project not in the file counts |
| 2 | Leads | Finish to Start relationships with negative lag |
| 3 | Lags | Relationships with positive lag |
| 4 | Long Lags | Relationships with lag above the configured day count |
| 5 | Relationship Types | Finish to Start relationships, as a share of all of them. Higher is better |
| 6 | Hard Constraints | Activities with Start On, Finish On, Mandatory Start or Mandatory Finish |
| 7 | Soft Constraints | Activities with a constraint that limits dates without fixing them |
| 8 | High Float | Incomplete activities with total float above the configured day count |
| 9 | Negative Float | Incomplete activities with total float below zero |
| 10 | High Duration | Incomplete non milestone activities with remaining duration above the configured day count |
| 11 | Invalid Progress Before | Incomplete activities whose remaining work starts before the data date |
| 12 | Invalid Progress After | Activities with actual dates after the data date |
| 13 | Resources | Non milestone activities with no resource assignment |
| 14 | Late Activities | Active activities whose early finish is later than their finish in the baseline |
| 15 | CPLI | Critical Path Length Index, a ratio. Higher is better |
| 16 | BEI | Baseline Execution Index, a ratio. Higher is better |
| 17 | Dangling Start Activities | Activities with predecessors but no FS or SS link driving their start |
| 18 | Dangling Finish Activities | Activities with successors but no FS or FF link driven by their finish |
| 19 | Out of Sequence | Activities progressed before the predecessor reached the state its relationship requires |
Missing Logic and checks 6 to 12 exclude Level of Effort and WBS summary rows, and High Duration, Resources, Late Activities and BEI also exclude milestones. That is why the count / total denominator differs between cards on the same schedule. A denominator that looks wrong is usually one of these exclusions rather than a fault.
What the checks measure against
| Denominator | Used by |
|---|---|
| Incomplete relationships | Leads, Lags, Long Lags, Relationship Types |
| Incomplete activities | Missing Logic, Hard and Soft Constraints, High Float, Negative Float |
| Incomplete non milestone activities | High Duration, Late Activities |
| All non milestone activities | Resources |
| All activities | Dangling Start, Dangling Finish, Out of Sequence |
BEI divides completed non milestone activities by the activities the baseline says should have finished by the data date. An activity the baseline does not have was added after it and is not counted as due.
The baseline BEI and Late Activities are measured against
The title bar shows it as Baseline: followed by its name. Click it to pick another: None (current schedule), the four baseline slots by their names, then the baselines saved inside a Microsoft Project file, MS Project Baseline and MS Project Baseline 1 to 10. A slot that none of the ticked projects has is greyed. Picking one runs the analysis again.

Left alone, it takes the first slot that holds a baseline, then the first baseline saved inside the file. A pick is kept for next time; when the ticked projects do not have it, the same rule picks one, and the title bar says which. Projects that do not have the baseline in use are left out of BEI and Late Activities.
With no baseline, BEI and Late Activities are not measured. Their cards turn grey with Needs a baseline: pick one above, or Needs a baseline: the schedule has none when no project has one, and they are left out of the score. Assign one under Manage Baseline on the same Tools tab, or pick one in the title bar.
A file with no data date
A Microsoft Project file whose status date was never set has no data date. The checks that compare with one then go by the schedule itself: when nothing has started, its planned start, shown in the left panel followed by (planned start); when work has started, the latest progress it records, an estimate, shown followed by (estimated).
On an estimate, Invalid Progress Before, CPLI and BEI are measured and their cards say Data date estimated from the latest progress. Invalid Progress After is not measured, since no actual date can be later than the latest progress. With nothing to go by, the four are not measured and say Needs a data date: the schedule has none.
The charts

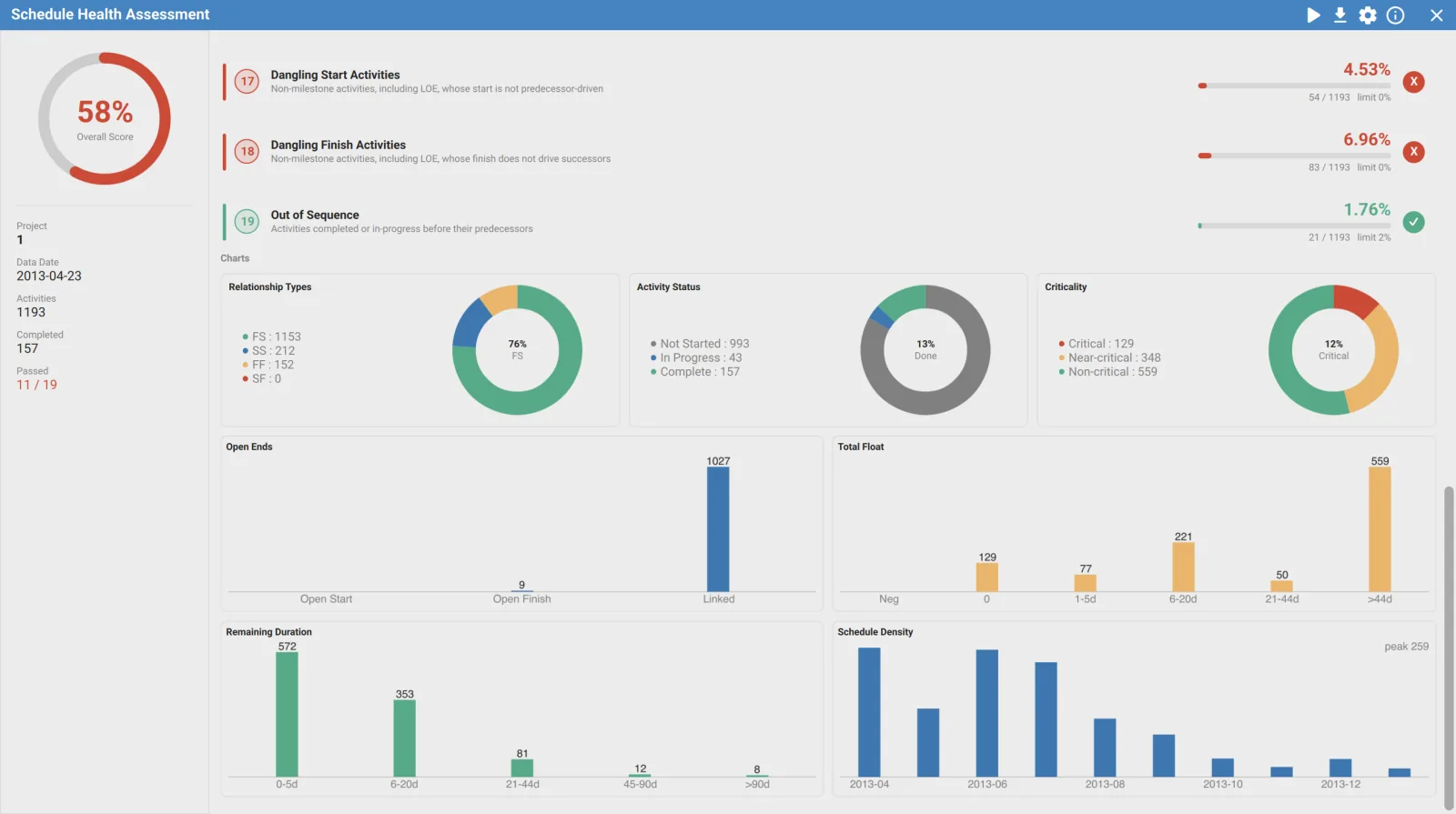

Below the cards, seven charts break the same data down by distribution rather than by pass and fail.

| Chart | Breakdown |
|---|---|
| Relationship Types | FS, SS, FF and SF counts, with the FS share in the centre |
| Activity Status | Not Started, In Progress and Complete |
| Criticality | Critical by the rule under Critical Activities in Preferences, by default as each project defines it; Near critical, the rest with total float up to the near critical limit in Parameters, 10 days by default; Non critical, beyond it. The chart says both rules under its title |
| Open Ends | Open Start, Open Finish and Linked, Level of Effort and WBS summary rows left out. A relationship to a project not in the file counts |
| Total Float | Neg, 0, 1 to 5d, 6 to 20d, 21 to 44d and above 44d |
| Remaining Duration | 0 to 5d, 6 to 20d, 21 to 44d, 45 to 90d and above 90d |
| Schedule Density | Activities starting each month, annotated with the peak. Grey for those already started, in the month they actually started; blue for those still to start, in the month planned. A dashed line marks the data date |
Total Float is the chart to read alongside the High Float card. The card gives one percentage; the chart shows whether the float is spread across the schedule or piled into a single bucket above 44 days, which points at a specific missing link rather than a general logic problem.
Days, in the charts, the day counts and the lists, are the project's working days: its calendar's hours a day, or Hours/Day in Preferences when the calendar is not used.
What each check means and how it is worked out

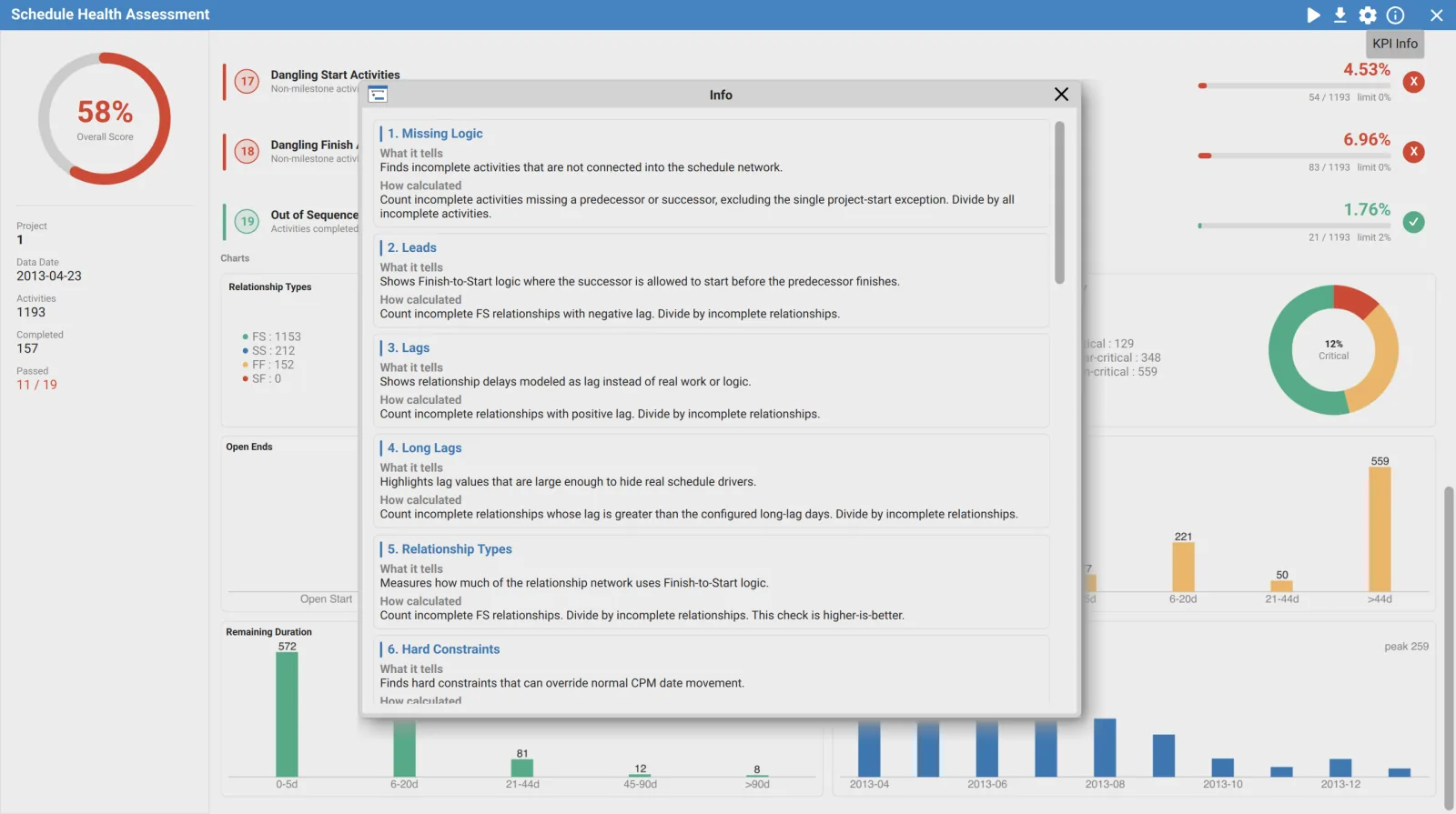

Put the pointer on the info button after a check's name. Its tooltip says What it tells and How calculated, with the exact numerator and denominator, which is what to quote when a result is challenged.

The title bar buttons
| Button | Effect |
|---|---|
| Baseline | The baseline BEI and Late Activities are measured against. Click it to pick another |
| Run | Re runs the analysis. Disabled while a run is in progress |
| Export PDF | Writes the full assessment report. Disabled until an analysis has completed |
| Parameters | Opens the threshold settings |
| Close | Returns to the activity view |
The buttons carry no captions. Hover one to see its name.
Changing the thresholds

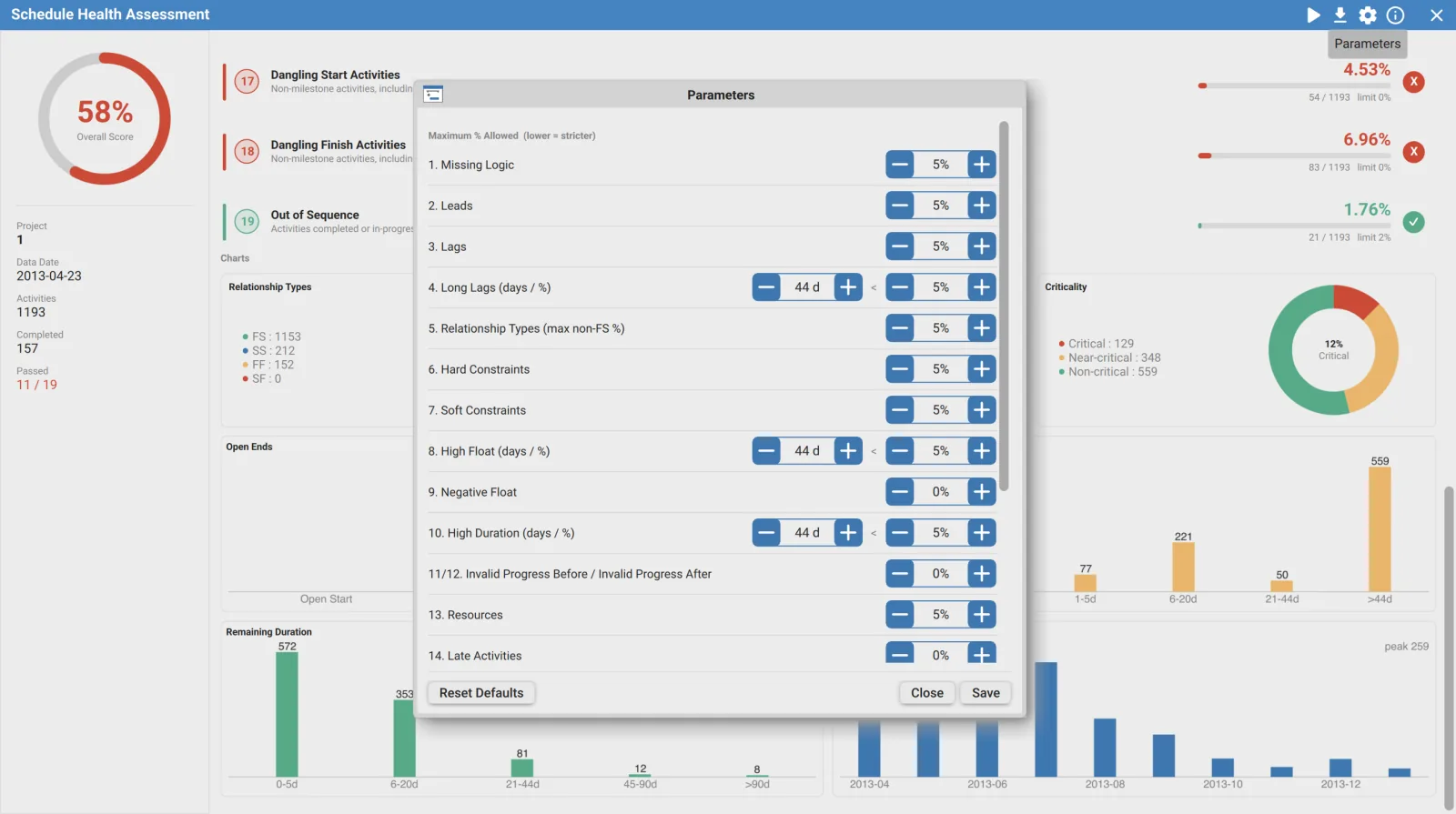

Parameters opens Maximum % Allowed (lower = stricter), one row per check.

| Row type | Fields |
|---|---|
| Single | One percentage limit |
| Long Lags, High Float, High Duration | A day count and a percentage. The day count defines what counts as long, high or excessive, in the project's working days; the percentage is how many of those the schedule may contain |
| 11/12 | Invalid Progress Before and Invalid Progress After share one limit |
| CPLI, BEI | A minimum rather than a maximum |
| Charts | How far near critical runs on the Criticality chart, in days |
| Default | Value |
|---|---|
| Most percentage limits | 5% |
| Negative Float, Invalid Progress, Late Activities, Dangling Start, Dangling Finish | 0% |
| Out of Sequence | 2% |
| Long lag, high float and high duration day counts | 44 days |
| CPLI and BEI minimum | 0.95 |
| Near critical limit | 10 days |
Saving parameters runs the analysis again with the new limits. After ticking other projects or changing Preferences, press Run to see the result of the change.
Reset Defaults opens a list of two. Application Default puts back the thresholds above. DCMA puts back the same with DCMA's figures for four of them: Leads 0%, Relationship Types at most 10% other than Finish to Start, Late Activities 5% and Resources 0%. Save keeps them, Close leaves without saving.
Analysing one project out of several
When the file holds more than one project, a project selector appears in the title bar to the left of Run. It is a checklist, not a single choice: tick the projects to include and the button label reports the selection as All Projects, a project name, or a count.
On a file with a single project the selector is hidden, because there is nothing to choose. Every project is ticked when the view opens, so the first run always covers the whole file.
Unticking the last remaining project is refused. The analyzer keeps at least one project selected, so you cannot arrive at an empty run.
The PDF report holds more than the screen
Export PDF writes a report named ScheduleAssessment.pdf by default, in these sections.
| Section | Content |
|---|---|
| Executive Summary | Score and headline figures, with the baseline |
| Schedule Logic Quality | The logic checks grouped together |
| Detailed Metrics | Every check with its value, limit and status. A check not measured shows N/A and why |
| Charts | The same seven charts |
| Recommendations | The failing checks only, ordered by severity, each with the corrective action |
| Check Methodology | The calculation behind each check |
| Analysis Parameters | The baseline and the thresholds the run used |
| Activity Details | The activities that failed each check, listed by ID |
Activity Details is the reason to export. The on screen cards give you a count; the report names the activities behind it, plus a table of external cross project relationships; those to projects not in the file are counted in Schedule Logic Quality but cannot be listed. Out of sequence progress is listed once: under check 19 when it fails, in a table of its own when it passes. Each table stops at 200 rows, and a heading ending in a plus sign means the check found more than were printed.
Recommendation severity is worked out from how far the value sits from its limit: at or beyond twice the limit, or below 80 percent of the minimum on the higher is better checks, a failure is ranked above the rest and printed first.
Requirements
Requires an open schedule with data and a signed in account. Clicking Schedule Analyzer while signed out opens the sign in dialog instead.
